Sunday, April 30, 2006

Bathroom Cabinets

Saturday, April 29, 2006

8.5 Weeks Overdue

The bathroom cabinets were finally delivered on Wednesday, and are now mostly installed. Otherwise, nothing happened this week.

Supposedly, next week should be busy:

  • The electrician is supposed to be back early in the week,
  • The brick is supposed to get installed around the foundation late in the week,
  • At one time, I was told the stainer would get started this week,
  • And, at one time, I was told the stairs would get re-done this week.

The finish carpenters appear to have a good 2-3 days left, so I’d guess that the stairs won’t get started until at least May 8. Even though it was supposed to be "no problem at all" to be done with everything in two weeks, I don’t think it will - but things might be close.

Sunday, April 23, 2006

Schedule

----- Original Message -----
From: [ME]
To: [CONTRACTOR]
Sent: Friday, April 14, 2006 3:05 PM
Subject: Schedule

Hey, [CONTRACTOR]:
I thought about it some, and I guess I don't see how the inside of my house is going to be done in 2 weeks - it would be great if it will be, but I don't think it's going to happen. It seems the earliest that [STAINING SUBCONTRACTOR] will get in there will be in 1.5 weeks, and I think it's going to take him a couple of weeks to do everything. And the stairs still need to be re-done - which I'm guessing will happen after [STAINING SUBCONTRACTOR] is done.
If things can get done by May 1, great. I would really, really like everything (including punchlist items - like patching the hole in the ceiling above the kitchen sink, finishing the wall switch patch in the south bedroom, switching out the bathroom door hinges, etc.) done by May 12. Is that a realistic expectation?
[ME]

-----
From: [CONTRACTOR]

Sent: Sat 4/15/2006 5:57 AM
To: [ME]
Subject: Re: Schedule

[Me],
I think May 12 will be no problem at all.
[CONTRACTOR]

-----
From: [ME]
To: [CONTRACTOR]
Sent: Thursday, April 20, 2006 5:44 PM
Subject: RE: Schedule

[CONTRACTOR]-
Are things still on track? I haven't seen any progress over the last 3 days.
[ME]

-----
From: [CONTRACTOR]
Sent: Thu 4/20/2006 9:23 PM
To: ME
Subject: Re: Schedule

I called [CABINET SUBCONTRACTOR] today to see when the cabinets will come (including the painted ones). He says they are at the painters and that he would call. I haven't heard back yet. It is very aggravating. I apologize. We will try to get the fence in tomorrow, and get the brick picked up. As soon as the cabinets get in I will have [FINISH CARPENTERS] finish the rest. [STAINING SUBCONTRACTOR] wants to start around May 1, and the flooring guys want to get in there that week as well. I think that all the cabinets and trim work will be done by the end of next week.
Sorry,
[CONTRACTOR]

7.5 Weeks Past 15-Week Contract End Date

Fence Me In

Sunset & Practical Beige



Sunday, April 16, 2006

6 Weeks Beyond the 15-Week Contract (November 15, 2005 - March 1, 2006)

Little Windows Get Installed

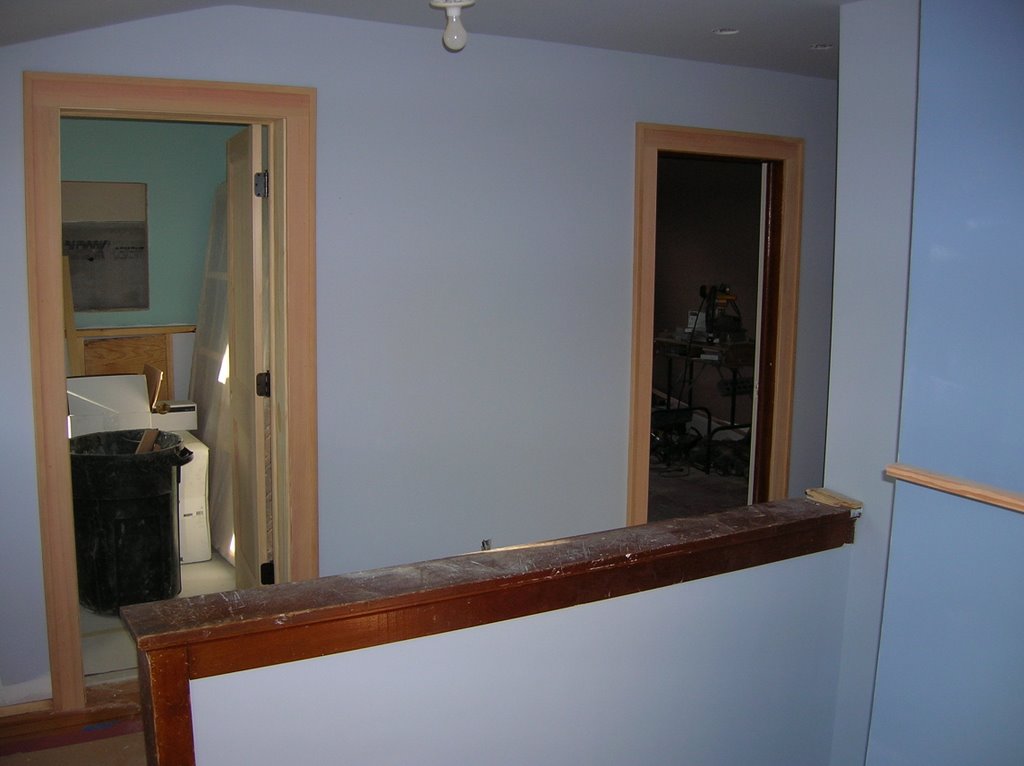

Upstair's Trim & Little Window


Start of Stair Trim

Kitchen Trim & Quarter Round

Mudroom Trim

Sunday, April 09, 2006

Real Red Becomes Teasing Peach


Saturday, April 08, 2006

Decongesting & Installing

Wednesday, April 05, 2006

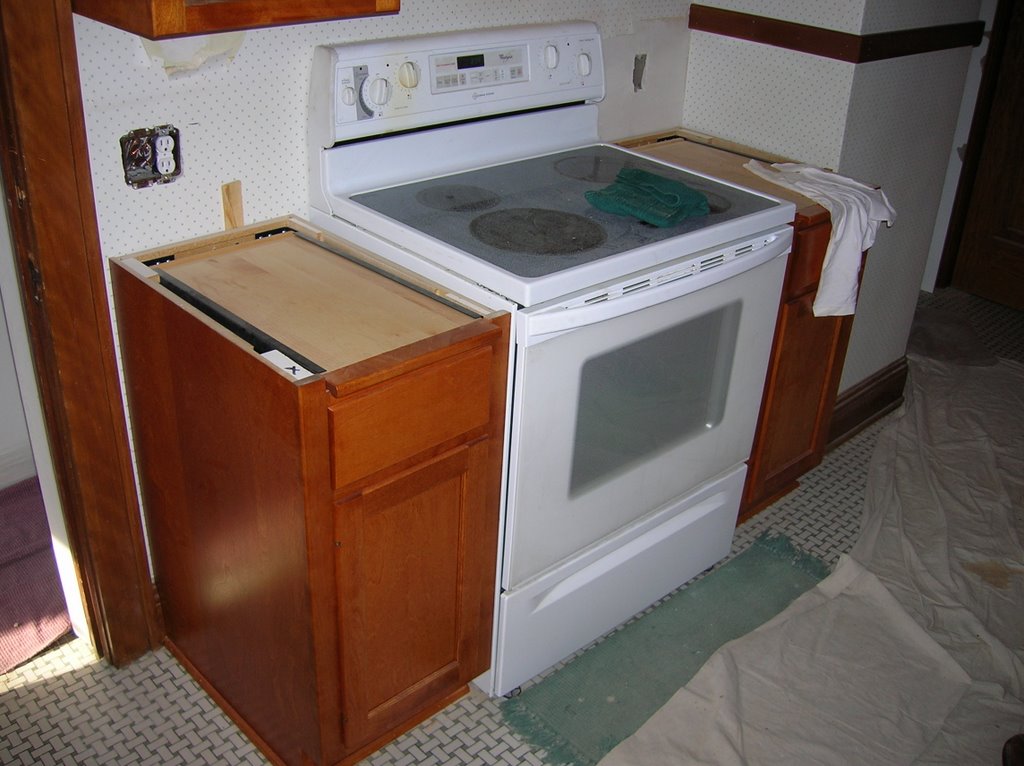

Some of the cabinets


Saturday, April 01, 2006

One Month After Contract Completion Date & 12th Anniversary of Owning the 233

Morris Room Grey

Real Red and Swing Brown

Upward and Bracing Blue
